Gantt Chart Template For Final Year Student Projects
Gantt Chart Template for Final Year Student Projects
A Gantt chart is an indispensable project management tool, particularly valuable for final year students tackling complex projects. It visually represents the project timeline, breaking it down into smaller, manageable tasks, assigning durations, and outlining dependencies. Using a well-structured Gantt chart template can significantly enhance organization, time management, and overall project success.
Benefits of Using a Gantt Chart Template
- Enhanced Organization: The template provides a clear, structured framework for planning and organizing all project activities. It forces you to think through each step involved, ensuring no crucial task is overlooked.
- Improved Time Management: By visualizing the project timeline, students can accurately estimate task durations and allocate sufficient time for each activity. This prevents last-minute rushes and helps maintain a realistic schedule.
- Dependency Identification: Gantt charts clearly illustrate task dependencies, highlighting which tasks must be completed before others can begin. This is critical for avoiding bottlenecks and ensuring a smooth workflow.
- Progress Tracking: As the project progresses, the Gantt chart allows for easy monitoring of task completion. It provides a visual representation of what has been accomplished and what remains, enabling timely adjustments if needed.
- Effective Communication: The chart serves as a clear communication tool, keeping all stakeholders (including supervisors, team members, and even yourself) informed about the project’s progress, milestones, and deadlines.
- Risk Mitigation: By identifying potential delays and dependencies early on, students can proactively address potential risks and develop contingency plans.
- Professionalism: Using a Gantt chart demonstrates a professional approach to project management, which is highly regarded by supervisors and can contribute to a higher grade.
Essential Elements of a Gantt Chart Template for Final Year Projects
A comprehensive Gantt chart template for final year projects should include the following key elements:
- Task List: This is a detailed list of all activities required to complete the project. Tasks should be broken down into manageable sub-tasks for better clarity and control.
- Start Date: The date on which each task is scheduled to begin.
- End Date: The date on which each task is expected to be completed.
- Duration: The estimated time required to complete each task, expressed in days, weeks, or months.
- Dependencies: This column specifies which tasks must be completed before a particular task can begin. For example, “Task C depends on Task A and Task B.”
- Resources: Allocate resources (e.g., team members, software, equipment) to each task to ensure accountability and efficient utilization.
- Progress: A column to track the percentage of completion for each task. This allows for easy monitoring of project progress.
- Milestones: Mark significant achievements or key deliverables within the project timeline. These milestones serve as checkpoints and help maintain momentum.
- Assignee: Indicate the person responsible for completing each task. This ensures accountability and prevents confusion.
- Notes/Comments: Include a space for adding notes, comments, or specific instructions related to each task. This provides additional context and facilitates communication.
Creating Your Gantt Chart Template
You can create a Gantt chart template using various tools, including:
- Spreadsheet Software (e.g., Microsoft Excel, Google Sheets): These offer basic Gantt chart functionality through formulas, conditional formatting, and chart creation tools. This is a free and readily available option for many students.
- Project Management Software (e.g., Microsoft Project, Asana, Trello, Monday.com): These provide more advanced features such as automated scheduling, resource management, and collaboration tools. Many offer free trials or educational licenses.
- Online Gantt Chart Tools (e.g., TeamGantt, GanttProject): These specialized tools are designed specifically for creating and managing Gantt charts. They often offer user-friendly interfaces and collaborative features.
Steps to Populate Your Gantt Chart Template:
- Define Project Scope: Clearly define the objectives, deliverables, and boundaries of your final year project.
- Break Down the Project: Decompose the project into smaller, manageable tasks and sub-tasks. Be as specific as possible.
- Estimate Task Durations: Accurately estimate the time required to complete each task, considering potential challenges and resource availability. Be realistic; overestimate rather than underestimate.
- Identify Task Dependencies: Determine which tasks must be completed before others can begin. Represent these dependencies clearly in your Gantt chart.
- Allocate Resources: Assign resources (e.g., team members, equipment, software) to each task.
- Set Start and End Dates: Based on task durations and dependencies, set realistic start and end dates for each task.
- Add Milestones: Identify key milestones within the project timeline and mark them on the Gantt chart. These milestones should represent significant achievements or deliverables.
- Populate the Gantt Chart: Enter all the information (task names, start dates, end dates, durations, dependencies, resources, etc.) into your chosen Gantt chart tool.
- Visualize the Timeline: Use the Gantt chart tool to visualize the project timeline, showing task durations and dependencies in a graphical format.
- Regularly Update the Chart: As the project progresses, regularly update the Gantt chart to reflect actual progress, changes in task durations, and any unforeseen challenges. This ensures the chart remains a useful tool for tracking and managing the project.

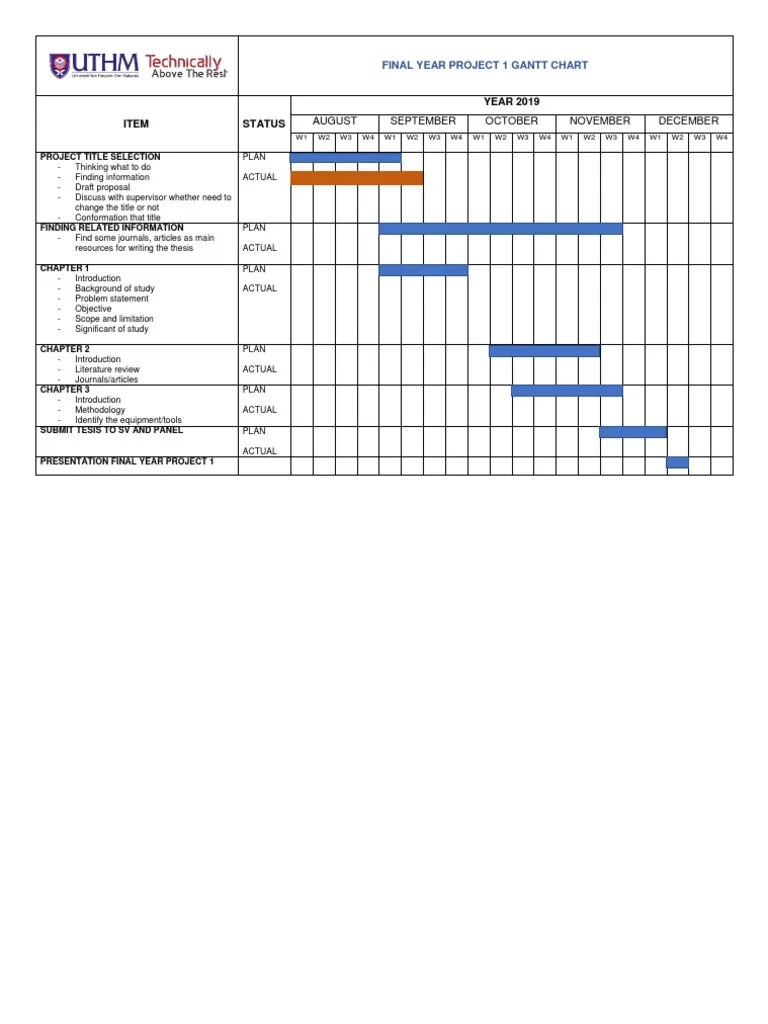

Example Task Breakdown for a Hypothetical Final Year Project: “Development of a Mobile Application”
- Phase 1: Project Planning and Requirements Gathering
- Task 1: Define Project Scope and Objectives (Duration: 2 days)
- Task 2: Conduct Literature Review and Market Research (Duration: 7 days)
- Task 3: Gather User Requirements (Duration: 5 days)
- Task 4: Create a Project Proposal (Duration: 3 days)
- Task 5: Supervisor Approval (Milestone)
- Phase 2: Design and Prototyping
- Task 6: Design User Interface (UI) and User Experience (UX) (Duration: 7 days)
- Task 7: Create a Prototype (Duration: 5 days)
- Task 8: User Testing and Feedback (Duration: 3 days)
- Task 9: Iterate on Design Based on Feedback (Duration: 5 days)
- Phase 3: Development
- Task 10: Set up Development Environment (Duration: 2 days)
- Task 11: Develop Backend Functionality (Duration: 14 days)
- Task 12: Develop Frontend Functionality (Duration: 14 days)
- Task 13: Integrate Backend and Frontend (Duration: 3 days)
- Phase 4: Testing and Quality Assurance
- Task 14: Conduct Unit Testing (Duration: 5 days)
- Task 15: Conduct Integration Testing (Duration: 3 days)
- Task 16: Conduct User Acceptance Testing (UAT) (Duration: 5 days)
- Task 17: Fix Bugs and Errors (Duration: 7 days)
- Phase 5: Documentation and Reporting
- Task 18: Write User Manual (Duration: 5 days)
- Task 19: Write Project Report (Duration: 7 days)
- Task 20: Prepare Presentation (Duration: 3 days)
- Phase 6: Final Submission and Presentation
- Task 21: Submit Final Project (Milestone)
- Task 22: Present Project (Milestone)
Conclusion
Utilizing a Gantt chart template is a highly effective strategy for managing final year student projects. By carefully planning, scheduling, and tracking progress, students can significantly increase their chances of completing their projects on time and within budget, while also demonstrating a professional approach to project management. Remember to regularly update your Gantt chart to reflect the project’s evolving status and make necessary adjustments to stay on track.
Thank you for visiting Gantt Chart Template For Final Year Student Projects. There are a lot of beautiful templates out there, but it can be easy to feel like a lot of the best cost a ridiculous amount of money, require special design. And if at this time you are looking for information and ideas regarding the Gantt Chart Template For Final Year Student Projects then, you are in the perfect place. Get this Gantt Chart Template For Final Year Student Projects for free here. We hope this post Gantt Chart Template For Final Year Student Projects inspired you and help you what you are looking for.
Gantt Chart Template For Final Year Student Projects was posted in January 11, 2026 at 6:54 am. If you wanna have it as yours, please click the Pictures and you will go to click right mouse then Save Image As and Click Save and download the Gantt Chart Template For Final Year Student Projects Picture.. Don’t forget to share this picture with others via Facebook, Twitter, Pinterest or other social medias! we do hope you'll get inspired by SampleTemplates123... Thanks again! If you have any DMCA issues on this post, please contact us!
